Miscellaneous steel detailing calls for a strong awareness of the design objective as well as the capacity to provide correct drawings and plans for fabrication and installation. Covering non-structural but vital elements including steps, handrails, guardrails, ladders, platforms, grates, gates, and ornamental metalwork, these elements are vital for the general safety, accessibility, and functionality of a structure. Our knowledge guarantees flawless integration into bigger steel constructions, fabrication-ready plans, and exact details. Our priorities are addressing difficult design problems, besting material use, and guaranteeing error-free deliveries, thereby lowering rework and saving money for our clients.
Miscellaneous steel detailing involves unique challenges due to the complexity of non-structural components. At Moldtek, we effectively manage these complexities by:
Ensuring precise integration of stairs, railings, and platforms within intricate architectural layouts through custom-adapted designs.
Eliminating fabrication errors and costly rework by maintaining high detailing accuracy with tight tolerances and precision.
Reducing waste through optimized material usage, preserving structural integrity.
Coordinating effectively with architects, engineers, and fabricators to fulfill both design intent and functional requirements.
Adhering strictly to industry standards (AISC, AWS, OSHA) to ensure safe, reliable, and code-compliant installations.
We deliver precise detailing that eliminates on-site errors, ensuring seamless project execution.
Our designs are tailored specifically to meet the unique requirements of every project.
Efficient processes enable quicker detailing, reducing overall project timelines.
Our advanced BIM integration facilitates smooth communication among engineers, architects, and fabricators.
Detailed and optimized designs significantly reduce material waste and lower overall project costs.
We have successfully executed projects across transportation, commercial, industrial, and infrastructure sectors.
Our detailing meets global compliance standards including AISC, AWS, BS, IS, CISC, and EURO Codes.
We leverage advanced technologies to deliver highly precise detailing, significantly reducing on-site errors.
Our customized approach ensures solutions are tailored specifically to meet unique project requirements.
We provide comprehensive detailing support including shop drawings, CNC-compatible outputs, BOMs, and field layouts.
Flexibility in design adaptation allows us to accommodate project-specific complexities efficiently.
Our efficient processes guarantee faster turnaround times, minimizing overall project timelines.
We use industry-leading software to ensure precision, efficiency, and seamless integration in steel detailing:
Advanced 3D modeling for accurate fabrication drawings.
Detailed 2D drafting and annotation customized to client requirements.
Comprehensive BIM-based steel detailing for efficient project execution.
Intelligent connection design ensuring precision and structural integrity.
Seamless coordination with structural and architectural components.
Our area of expertise is providing a wide spectrum of random miscellaneous steel detailing services, including:
Following worldwide steel detailing guidelines and standards guarantees conformity with:
AISC (American Institute of Steel Construction).
AWS, or American Welding Society
Relevant Building Regulations British Standards: OSHA BS
Indian Standards, or IS
Canadians Institute of Steel Construction, or CISC
Euro Codes
We are a reliable partner for various metal details since we are dedicated to excellence, precision, and creativity. Get in touch right now to go over your project needs and enjoy expertise in various steel detailing techniques!

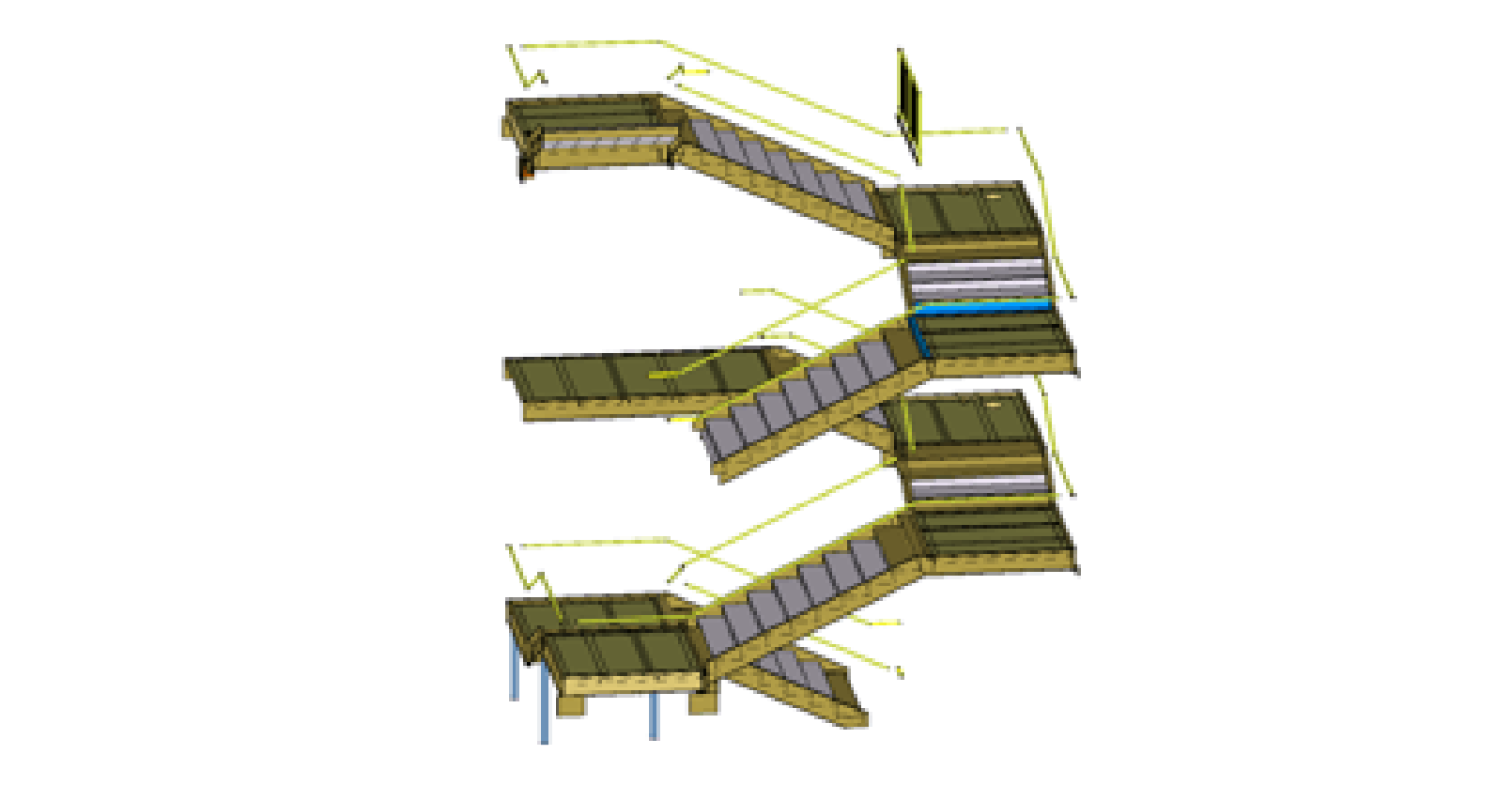

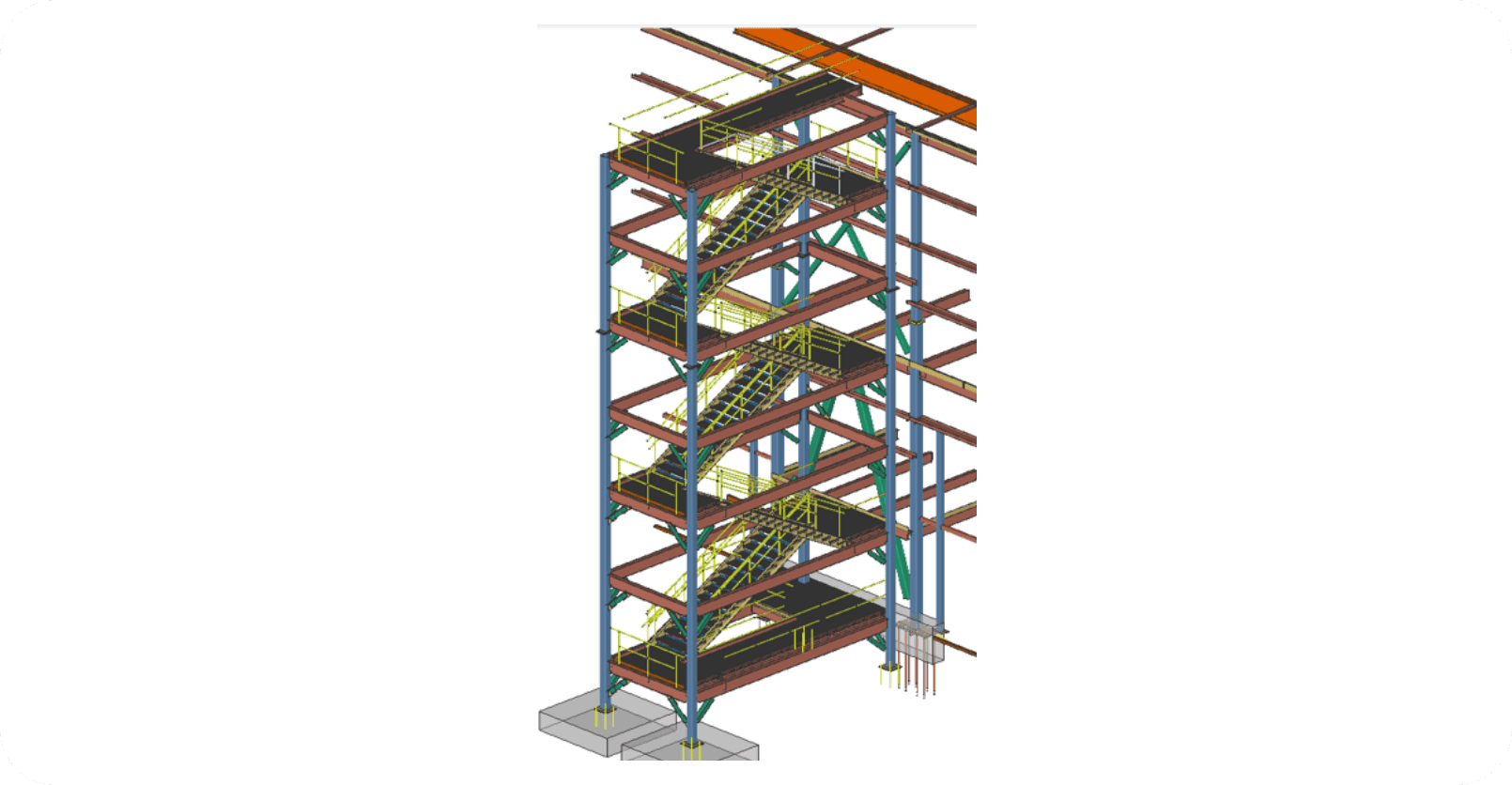

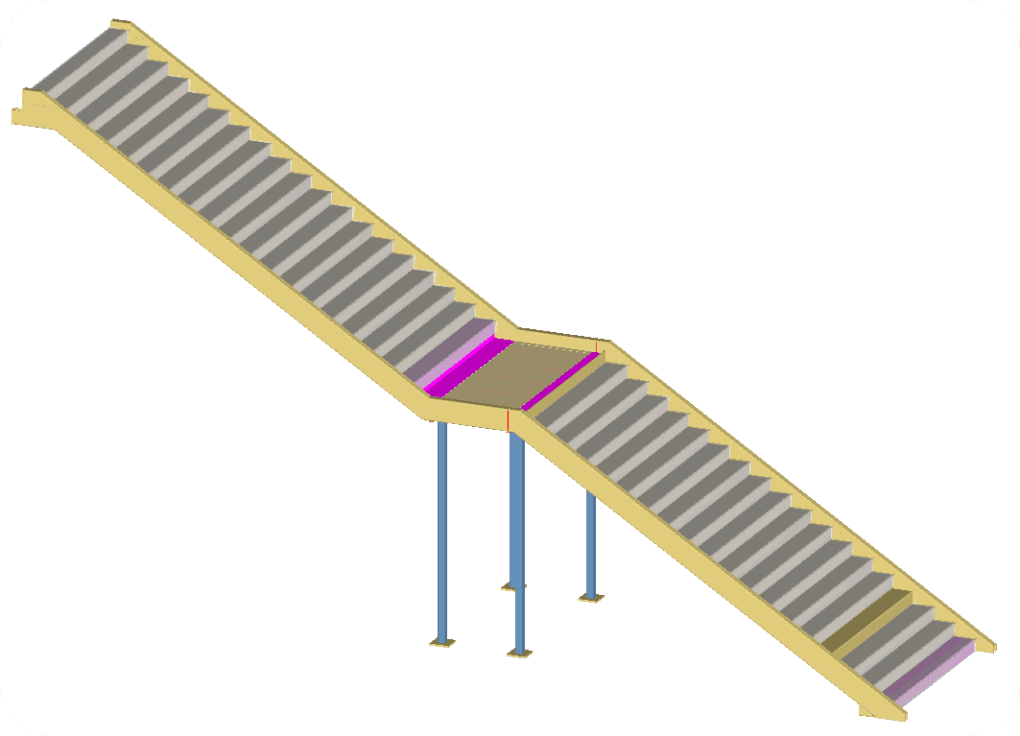

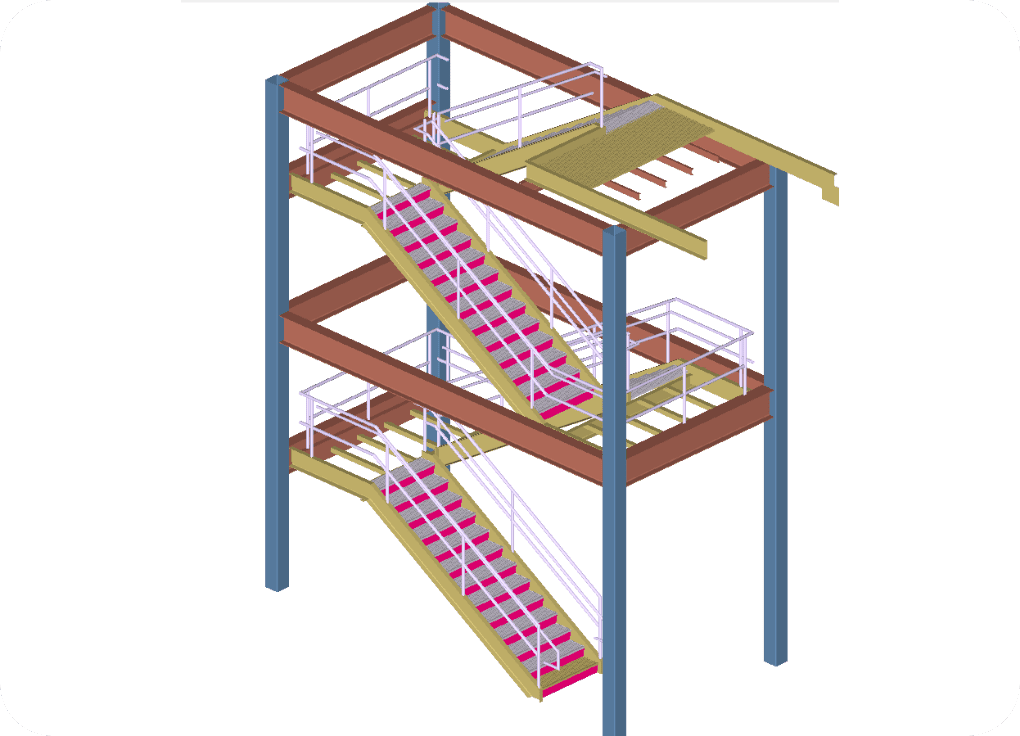

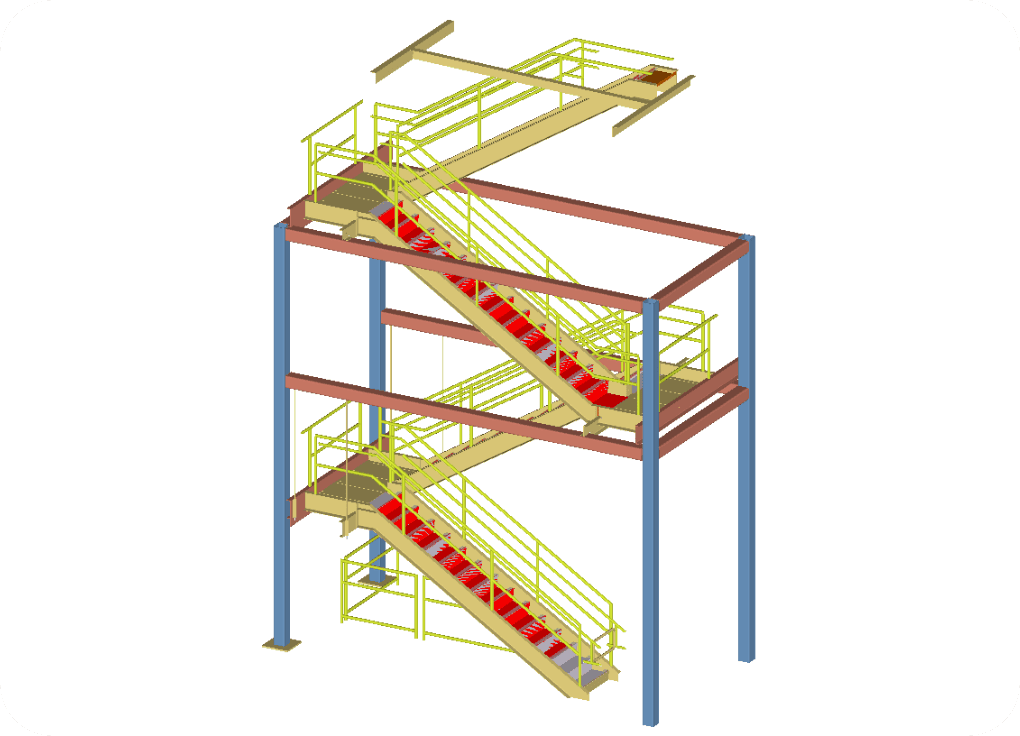

Designed for modern living, the ambitious 49-story twin-building project known as the 80 Rainey Residential Tower stands at 80 Rainey St., Austin, Texas. Comprising 144 tons of steel, this commercial high-rise needed careful detailing and coordination to guarantee the perfect integration of five stairs and seven single-flight steps inside the construction.
For stair connections, our team had special difficulty matching primary steel framing and embeds. These components need perfect coordination with the main structural steel team and close cooperation with it.
Our method was proactive and meticulous to fit the eighteen-week timeline of the project. Every embed and connecting point aligned exactly by closely timing our detailed efforts with the main framing. We effectively reduced possible conflicts and simplified the building process by offering several entries and constant coordination.
With a 12-week approval lead time and 8 weeks for fabrication, our method guaranteed early completion. Starting in January 2023, the project was carried out precisely, therefore highlighting our knowledge of various steel detailing and our capacity to effectively negotiate challenging tasks.

The NewCold Indianapolis Phase 2 commercial refrigeration facility, housed at Edward Drive, Lebanon, Indiana, calls for very specific miscellaneous steel detailing. This project involved the detailing and fabrication of an external dock stair, interior dispatch crossover stair, interior egress stair, interior high bay stair, many minor stairs, ladders, and other miscellaneous scope items with a total steel tonnage of 200 tons.
Ensuring appropriate alignment of embeds and primary steel framing—two essential components for stair connections—was one of the toughest tasks involved. Furthermore, field conditions required changes to several stair designs that needed flexibility and quick updates to keep the project efficient.
Our team closely worked with the primary steel team to ensure flawless integration of all stair connections, thereby meeting the 8-week project timetable. Using several repetitions and proactive correspondence, we effectively adjusted to field conditions while preserving precision in detailing.
Our method guaranteed flawless execution with an 8-week approval lead time and an extra 4 weeks for fabrication. Starting in April 2023, the project was completed on schedule, therefore validating our knowledge in handling challenging various steel detailing for industrial buildings and refrigeration.
